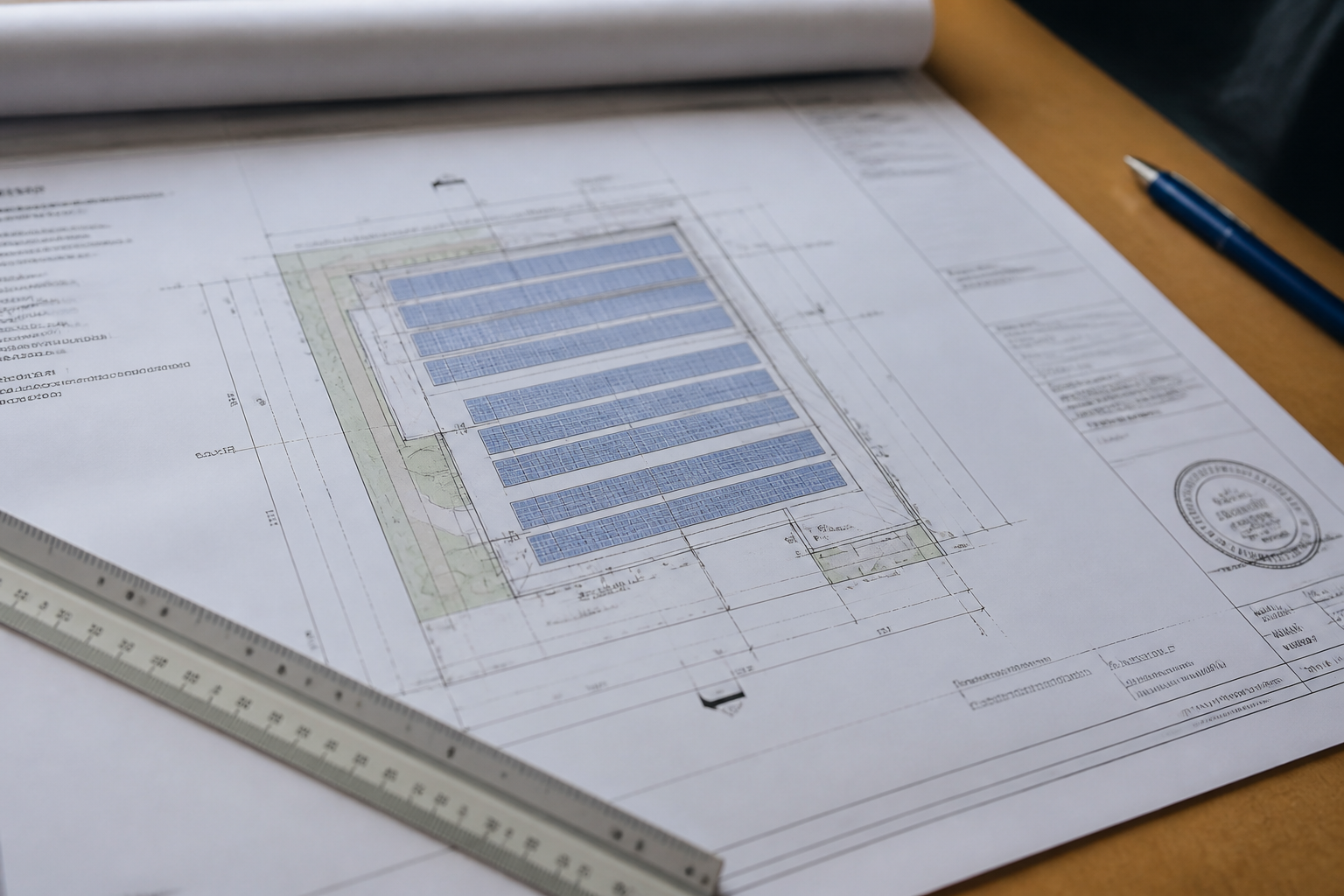

A PE stamp on a solar plan set means a licensed professional engineer took responsible charge of the engineering work on that sheet and is willing to be identified by name and license number. It does not mean the town promised to approve the job. It does not mean the utility issued permission to operate. It does not mean the installer is NABCEP certified.
If a reviewer asked what a PE stamp means for solar, that is the short version. The longer version is about scope, state lines, and what happens when the field changes.
Responsible charge
State rules say you do not seal work prepared by an unlicensed person unless it was performed under your responsible charge. Rhode Island’s regulation states that in plain language. Other Northeast boards have the same idea. A PE stamp solar sheet is not a courtesy signature on a contractor’s CAD.
If Athol Energy seals a set, an engineer licensed in that state had charge of the engineering content. That is the product.
Which sheets get the round (or square) stamp
Structural sheets and calcs. Electrical one-lines and panel schedules. Sometimes both. Rarely the marketing cover. Stamping every page including the cut-sheet appendix can be required or forbidden depending on the AHJ. Follow the board and the city, not a habit from another state.
Rhode Island wants a square stamp of specified size. Massachusetts wants a 1-1/2 inch circular seal with the statutory wording. Using the wrong geometry is a needless reject.
Wet vs digital on the PDF you upload
Many boards allow electronic seals if they are unique, verifiable, and under the licensee’s control, and if the receiving agency accepts electronic records. Massachusetts materials describe encrypted digital signatures that break if the file is changed. Rhode Island points at UETA and encoded electronic signatures.
Some AHJs still want a wet-stamped paper set in the field folder. Ask. Ship both if the town is mixed. Do not assume Boston’s electronic intake equals a coastal town’s counter.
What the stamp does not cover
Construction means and methods you did not design. A module the crew swapped after issuance. An interconnection application filed with a different inverter. If the field changed, the PE stamp on the old set does not magically cover the new array. File a revision or an as-built sealed by the engineer of record.
PTO is still the utility’s letter.
How installers should talk about it
Say “PE-stamped structural letter, Massachusetts license” or “electrical PE, New York.” Do not say “engineered” as a vibe word. Do not say “NABCEP stamped.”
Athol Energy: PE stamping on permit design packages for MA, RI, CT, NY, and PA. If you only need CAD without a seal, say so. If the AHJ requires a seal, say that too. Mixing those on the PO is how sets go out naked.
A PE stamp solar drawing is a named person taking a named risk. Treat it that way.
Title block hygiene
License number readable. State name correct. Date next to the seal. Revision that matches the sheet. If you copy last month’s title block and leave “Massachusetts” on a Cranston job, the stamp is lying.
Clouded changes after a seal need a new seal or a documented addendum, depending on the board and the change. Do not white-out.
Inspector conversations
Inspectors argue with drawings, not with vibes. If they say the stamp is missing, get the PE set to the site. If they say the stamp is fine but the wire size is wrong, that is a design comment, not a seal comment. Do not call the engineer to “explain” a missing conductor.
PE stamp solar packages should travel with the issued permit. The truck copy should be the issued revision, not the sales layout.
Athol Energy will resend a sealed PDF the same day if the superintendent grabbed the wrong file. We would rather do that than argue with ISD.
After a failed inspection
If the fail is missing stamp, resend the sealed set. If the fail is a design item, revise and reseal. Do not send the old PE stamp solar PDF with a sticky note. Inspectors have seen that trick.
Keep a log of which revision was on site. Superintendents grab the wrong print. That is an ops problem, not an engineering mystery.
If two PEs touch a set, mark who sealed structure and who sealed electrical. Dual PE stamp solar packages confuse clerks when both seals sit on the same sheet with no scope note. Rhode Island even wants discipline on the stamp when applicable. Make the paper obvious. Keep the engineer’s email on the job folder. When an inspector asks a PE stamp solar question at 7 a.m., the superintendent should not have to hunt Slack.
